Walliston Primary School

Switchboard Replacement & Electrical Infrastructure Upgrade

NJP Electrical Workspace

Completed

January 2026

Walliston Primary School
PROJECT OVERVIEW

NJP Electrical Workspace delivered a staged switchboard replacement and electrical infrastructure upgrade at Walliston Primary School for Programmed Facility Management, under Safeway Construction, within a live operational school environment.

The project involved modification of the existing Site Main Switchboard and full replacement of the Senior Block Building Main Switchboard, including new submains, underground reticulation and complete reconnection of existing circuits.

The upgrade was completed to increase available electrical capacity and allow for the installation of additional split system air-conditioning units across the school. All works were undertaken during the December–January shutdown period to ensure zero disruption to school operations.

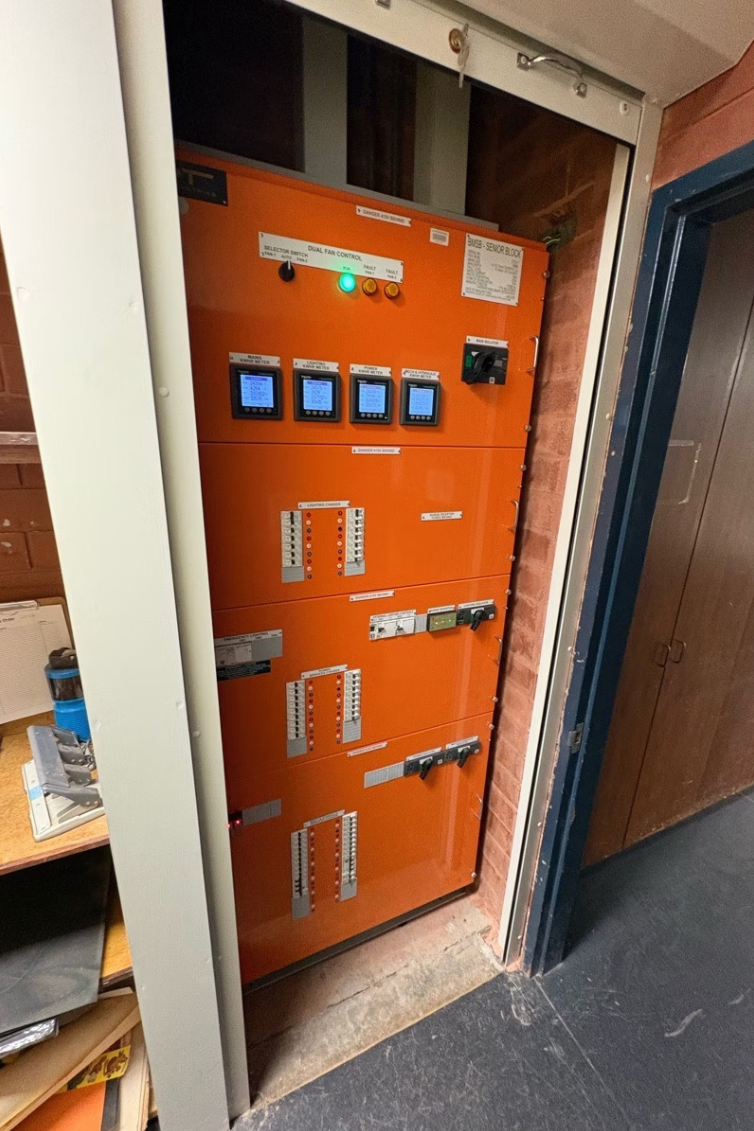

Project 2
Delivery Approach

All works were carefully staged during the school’s December–January shutdown period, ensuring continuity of essential services and zero disruption to operations.

Cal

Phase 1
Planning

User Img

Phase 2
Generator

Phase 3

Phase 3
Switchboard

Phase 4

Phase 4
Testing

Effective coordination between the client, builder and utility provider ensured the project was delivered within strict programmed shutdown timeframes with no unplanned outage

PROJECT TEAM

Key Stakeholders

Your content goes here. Edit or remove this text inline or in the module Content settings. You can also style every aspect of this content in the module Design settings and even apply custom CSS to this text in the module Advanced settings.

Client

Programmed Facility Management

Builder

Safeway Construction

Electrical Contractor

NJP Electrical Service

Scope of Works

A comprehensive electrical infrastructure upgrade delivered across multiple disciplines, from switchboard fabrication to underground reticulation and utility coordination.

Switchboard Works

  • Modification and extension of existing Site Main Switchboard
  • Replacement of Senior Block Main Switchboard to current AS/NZS standards

Underground Infrastructure

  • Installation of new submains and underground heavy duty conduit systems
  • Trenching, cable pit installation and full surface reinstatement

Power Management

  • Temporary generator supply during Western Power disconnection
  • Coordination with Western Power and staged shutdown management

Commissioning & Handover

  • Reconnection, auditing and relabelling of all existing circuits
  • Testing, commissioning and delivery of as-constructed documentation

Key Outcomes

1

Increased Capacity

Increased site electrical capacity to support additional split system air-conditioning installations across the school.

2

On-Time Delivery

Delivered within strict programmed shutdown timeframes during the December–January school holiday period.

3

Zero Disruption

Zero unplanned outages to critical services throughout the entire project duration.

4

Full Compliance

Full compliance with AS/NZS 3000 and AS/NZS 61439 standards, with effective coordination between all stakeholders.

Project Summary

The Walliston Primary School switchboard replacement demonstrates NJP Electrical Workspace’s capability to deliver complex electrical infrastructure upgrades within live operational environments and strict programmed timeframes.

From staged shutdowns and utility coordination to full compliance with Australian standards, this project was completed with precision, safety and zero disruption to school operations.

At a Glance

  • Client: Programmed Facility Management
  • Builder: Safeway Construction
  • Completion: January 2026
  • Standards: AS/NZS 3000 & AS/NZS 61439
  • Disruption: Zero unplanned outages
